Expansion of Hong Kong International Airport into a Three-Runway System

Construction Phase Monthly EM&A Report No.43 (For July 2019)

August 2019

Contents

Abbreviations

Executive Summary

1      Introduction

1.1    Background

1.2    Scope of this Report

1.3    Project Organisation

1.4    Summary of Construction Works

1.5    Summary of EM&A Programme Requirements

2      Air Quality Monitoring

2.1    Action and Limit Levels

2.2    Monitoring Equipment

2.3    Monitoring Methodology

2.3.1     Measuring Procedure

2.3.2     Maintenance and Calibration

2.4    Summary of Monitoring Results

2.5    Conclusion

3      Noise Monitoring

3.1    Action and Limit Levels

3.2    Monitoring Equipment

3.3    Monitoring Methodology

3.3.1     Monitoring Procedure

3.3.2     Maintenance and Calibration

3.4    Summary of Monitoring Results

3.5    Conclusion

4      Water Quality Monitoring

4.1    Action and Limit Levels

4.2    Monitoring Equipment

4.3    Monitoring Methodology

4.3.1     Measuring Procedure

4.3.2     Maintenance and Calibration

4.3.3     Laboratory Measurement / Analysis

4.4    Summary of Monitoring Results

4.5    Conclusion

5      Waste Management

5.1    Action and Limit Levels

5.2    Waste Management Status

6      Chinese White Dolphin Monitoring

6.1    Action and Limit Levels

6.2    CWD Monitoring Transects and Stations

6.2.1     Small Vessel Line-transect Survey

6.2.2     Land-based Theodolite Tracking Survey

6.3    CWD Monitoring Methodology

6.3.1     Small Vessel Line-transect Survey

6.3.2     Photo Identification

6.3.3     Land-based Theodolite Tracking Survey

6.4    Monitoring Results and Observations

6.4.1     Small Vessel Line-transect Survey

6.4.2     Photo Identification

6.4.3     Land-based Theodolite Tracking Survey

6.5    Progress Update on Passive Acoustic Monitoring

6.6    Site Audit for CWD-related Mitigation Measures

6.7    Timing of Reporting CWD Monitoring Results

6.8    Summary of CWD Monitoring

7      Environmental Site Inspection and Audit

7.1    Environmental Site Inspection

7.2    Audit of SkyPier High Speed Ferries

7.3    Audit of Construction and Associated Vessels

7.4    Implementation of Dolphin Exclusion Zone

7.5    Status of Submissions under Environmental Permits

7.6    Compliance with Other Statutory Environmental Requirements

7.7    Analysis and Interpretation of Complaints, Notification of Summons and Status of Prosecutions

7.7.1     Complaints

7.7.2     Notifications of Summons or Status of Prosecution

7.7.3     Cumulative Statistics

8      Future Key Issues and Other EIA & EM&A Issues

8.1    Construction Programme for the Coming Reporting Period

8.2    Key Environmental Issues for the Coming Reporting Period

8.3    Monitoring Schedule for the Coming Reporting Period

8.4    Review of the Key Assumptions Adopted in the EIA Report

9      Conclusion and Recommendation

Tables

Table 1.1: Contact Information of Key Personnel 8

Table 1.2: Summary of status for all environmental aspects under the Updated EM&A Manual 10

Table 2.1:  Locations of Impact Air Quality Monitoring Stations  13

Table 2.2:  Action and Limit Levels of Air Quality Monitoring  13

Table 2.3:  Air Quality Monitoring Equipment 13

Table 2.4: Summary of Air Quality Monitoring Results  14

Table 3.1: Locations of Impact Noise Monitoring Stations  15

Table 3.2: Action and Limit Levels for Noise Monitoring  15

Table 3.3: Noise Monitoring Equipment 16

Table 3.4: Summary of Construction Noise Monitoring Results  17

Table 4.1: Monitoring Locations and Parameters of Impact Water Quality Monitoring  18

Table 4.2: Action and Limit Levels for General Water Quality Monitoring and Regular DCM Monitoring  20

Table 4.3: The Control and Impact Stations during Flood Tide and Ebb Tide for General Water Quality Monitoring and Regular DCM Monitoring  20

Table 4.4: Water Quality Monitoring Equipment 21

Table 4.5: Other Monitoring Equipment 21

Table 4.6: Laboratory Measurement/ Analysis of SS and Heavy Metals  22

Table 4.7: Summary of DO (Surface and Middle) Compliance Status (Mid-Ebb Tide) 23

Table 4.8: Summary of DO (Bottom) Compliance Status (Mid-Ebb Tide) 23

Table 4.9: Summary of DO (Surface and Middle) Compliance Status (Mid-Flood Tide) 23

Table 4.10: Summary of DO (Bottom) Compliance Status (Mid-Flood Tide) 24

Table 4.11: Summary of Findings from Investigation of DO Monitoring Results  24

Table 5.1: Action and Limit Levels for Construction Waste  26

Table 5.2: Construction Waste Statistics  26

Table 6.1: Derived Values of Action and Limit Levels for Chinese White Dolphin Monitoring  27

Table 6.2: Coordinates of Transect Lines in NEL, NWL, AW, WL and SWL Survey Areas  28

Table 6.3: Land-based Theodolite Survey Station Details  29

Table 6.4: Comparison of CWD Encounter Rates of the Whole Survey Area with Action Levels  33

Table 6.5: Summary of Photo Identification  34

Table 6.6: Summary of Survey Effort and CWD Group of Land-based Theodolite Tracking  35

Table 7.1: Summary of Key Audit Findings against the SkyPier Plan  40

Table 7.2: Status of Submissions under Environmental Permit 41

Figures

Figure 1.1

Locations of Key Construction Activities

Figure 1.2

Latest Layout of the Enhanced Silt Curtain

Figure 2.1

Locations of Air and Noise Monitoring Stations and Chek Lap Kok Wind Station

Figure 4.1

Water Quality Monitoring Stations

Figure 6.1

Vessel based Dolphin Monitoring Transects in Construction, Post-construction and Operation Phases

Figure 6.2

Land based Dolphin Monitoring in Baseline and Construction Phases

Figure 6.3

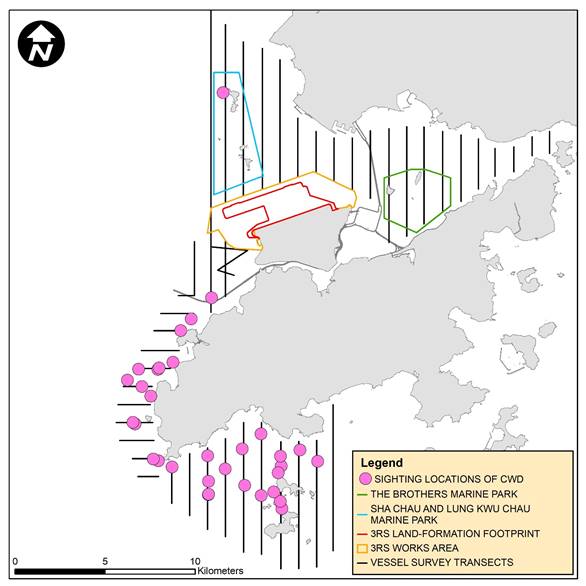

Sightings Distribution of Chinese White Dolphins

Figure 6.4

Plots of First Sightings of All CWD Groups obtained from Land-based Stations

Figure 6.5

Location for Autonomous Passive Acoustic Monitoring

Figure 7.1

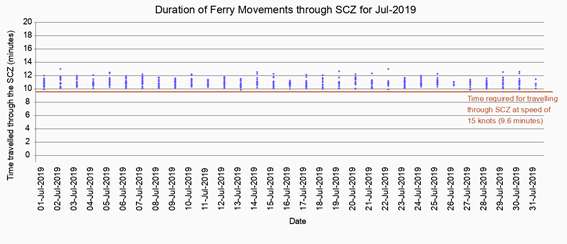

Duration of the SkyPier HSFs travelled through the SCZ for July 2019

Appendices

Appendix A

Environmental Mitigation Implementation Schedule (EMIS) for Construction Phase

Appendix B

Monitoring Schedule

Appendix C

Monitoring Results

Appendix D

Calibration Certificates

Appendix E

Status of Environmental Permits and Licences

Appendix F

Cumulative Statistics on Exceedances, Environmental Complaints, Notification of Summons and Status of Prosecutions

Appendix G

Data of SkyPier HSF Movements to/from Zhuhai and Macau (between 1 and 31 July 2019)

Abbreviations

3RS

Three-Runway System

AAHK

Airport Authority Hong Kong

AECOM

AECOM Asia Company Limited

AFCD

Agriculture, Fisheries and Conservation Department

AIS

Automatic Information System

ANI

Encounter Rate of Number of Dolphins

APM

Automated People Mover

AW

Airport West

BHS

Baggage Handling System

C&D

Construction and Demolition

CAP

Contamination Assessment Plan

CAR

Contamination Assessment Report

CNP

Construction Noise Permit

CWD

Chinese White Dolphin

DCM

Deep Cement Mixing

DEZ

Dolphin Exclusion Zone

DO

Dissolved Oxygen

EAR

Ecological Acoustic Recorder

EIA

Environmental Impact Assessment

EM&A

Environmental Monitoring & Audit

EP

Environmental Permit

EPD

Environmental Protection Department

ET

Environmental Team

FCZ

Fish Culture Zone

HDD

Horizontal Directional Drilling

HKBCF

Hong Kong-Zhuhai-Macao Bridge Hong Kong Boundary Crossing Facilities

HKIA

Hong Kong International Airport

HOKLAS

Hong Kong Laboratory Accreditation Scheme

HSF

High Speed Ferry

HVS

High Volume Sampler

IEC

Independent Environmental Checker

LKC

Lung Kwu Chau

MMHK

Mott MacDonald Hong Kong Limited

MMWP

Marine Mammal Watching Plan

MSS

Marine Surveillance System

MTRMP-CAV

Marine Travel Routes and Management Plan for Construction and Associated Vessel

NEL

Northeast Lantau

NWL

Northwest Lantau

PAM

Passive Acoustic Monitoring

PVD

Prefabricated Vertical Drain

SC

Sha Chau

SCLKCMP

Sha Chau and Lung Kwu Chau Marine Park

SS

Suspended Solids

SSSI

Site of Special Scientific Interest

STG

Encounter Rate of Number of Dolphin Sightings

SWL

Southwest Lantau

T2

Terminal 2

The Project

The Expansion of Hong Kong International Airport into a Three-Runway System

The SkyPier Plan

Marine Travel Routes and Management Plan for High Speed Ferries of SkyPier

The Manual

The Updated EM&A Manual

TSP

Total Suspended Particulates

WL

West Lantau

WMP

Waste Management Plan

Executive Summary

The “Expansion of Hong Kong International Airport into a Three-Runway System” (the Project) serves to meet the future air traffic demands at Hong Kong International Airport (HKIA). On 7 November 2014, the Environmental Impact Assessment (EIA) Report (Register No.: AEIAR-185/2014) for the Project was approved and an Environmental Permit (EP) (Permit No.: EP-489/2014) was issued for the construction and operation of the Project.

Airport Authority Hong Kong (AAHK) commissioned Mott MacDonald Hong Kong Limited (MMHK) to undertake the role of Environmental Team (ET) for carrying out the Environmental Monitoring & Audit (EM&A) works during the construction phase of the Project in accordance with the Updated EM&A Manual (the Manual).

This is the 43rd Construction Phase Monthly EM&A Report for the Project which summarizes the monitoring results and audit findings of the EM&A programme during the reporting period from 1 to 31 July 2019.

Key Activities in the Reporting Period

The key activities of the Project carried out in the reporting period included reclamation works and land-side works. Reclamation works included deep cement mixing (DCM) works, marine filling, and seawall construction. Land-side works involved mainly airfield works, foundation and substructure work for Terminal 2 expansion, modification and tunnel work for Automated People Mover (APM) and Baggage Handling System (BHS), and preparation work for utilities, with activities include site establishment, site office construction, road and drainage works, cable ducting, demolition, piling, and excavation works.

EM&A Activities Conducted in the Reporting Period

The monthly EM&A programme was undertaken in accordance with the Manual of the Project. Summary of the monitoring activities during this reporting period is presented as below:

Monitoring Activities

Number of Sessions

1-hour Total Suspended Particulates (TSP) air quality monitoring

30

Noise monitoring

16

Water quality monitoring

13

Vessel line-transect surveys for Chinese White Dolphin (CWD) monitoring

2

Land-based theodolite tracking survey effort for CWD monitoring

3

Environmental auditing works, including weekly site inspections of construction works conducted by the ET and bi-weekly site inspections conducted by the Independent Environmental Checker (IEC), audit of SkyPier High Speed Ferries (HSF), audit of construction and associated vessels, and audit of implementation of Marine Mammal Watching Plan (MMWP) and Dolphin Exclusion Zone (DEZ) Plan, were conducted in the reporting period. Based on information including ET’s observations, records of Marine Surveillance System (MSS), and contractors’ site records, it is noted that environmental pollution control and mitigation measures were properly implemented and construction activities of the Project in the reporting period did not introduce adverse impacts to the sensitive receivers.

Snapshots of EM&A Activities in the Reporting Period

Noise Monitoring Conducted by ET at Tin Sum

Land-Based CWD Theodolite Tracking Survey Conducted by ET on Lung Kwu Chau

Water Spraying by Contractor for Dust Control

Results of Impact Monitoring

The monitoring works for construction dust, construction noise, water quality, construction waste, landscape & visual, and CWD were conducted during the reporting period in accordance with the Manual.

Monitoring results of construction dust, construction noise, construction waste, and CWD did not trigger the corresponding Action and Limit Levels in the reporting period.

The water quality monitoring results for turbidity, total alkalinity, SS, chromium and nickel obtained during the reporting period were within the corresponding Action and Limit Levels stipulated in the EM&A programme. Relevant investigation and follow-up actions will be conducted according to the EM&A programme if the corresponding Action and Limit Levels are triggered. For dissolved oxygen (DO), some testing results triggered the relevant Action or Limit Levels, and the corresponding investigations were conducted accordingly. The investigation findings concluded that the case was not related to the Project. To conclude, the construction activities in the reporting period did not introduce adverse impact to all water quality sensitive receivers.

Summary of Upcoming Key Issues

Advanced Works:

Contract P560 (R) Aviation Fuel Pipeline Diversion Works

    Stockpiling of compressed materials

DCM Works:

Contract 3201 and 3205 DCM works

    DCM works

Reclamation Works:

Contract 3206 Main Reclamation Works

    Land base ground improvement works;

    Seawall construction; and

    Marine filling.

Airfield Works:

Contract 3301 North Runway Crossover Taxiway

    Cable ducting works;

    Subgrade compaction and paving works;

    Drainage construction works;

    Operation of aggregate mixing facility; and

    Precast of duct bank and fabrication of steel works.

Contract 3302 Eastern Vehicular Tunnel Advance Works

    Site survey and cable laying;

    Excavation works;

    Backfilling and reinstatement works; and

    Site establishment.

Contract 3303 Third Runway and Associated Works

    Site establishment.

Third Runway Concourse and Integrated Airport Centres Works:

Contract 3402 New Integrated Airport Centres Enabling Works

    Sub-structure and superstructure works;

    Structural steel fabrication;

    Paving works; and

    Manhole and pipe construction works.

Terminal 2 Expansion Works:

Contract 3501 Antenna Farm and Sewage Pumping Station

    Drainage works;

    Boring works; and

    Pipe installation.

Contract 3502 Terminal 2 Automated People Mover (APM) Depot Modification Works

    Site clearance; and

    Fitting out works.

Contract 3503 Terminal 2 Foundation and Substructure Works

    Site establishment;

    Demolition works;

    Utilities, drainage, and road work; and

    Piling and structure works.

Automated People Mover (APM) Works:

Contract 3602 Existing APM System Modification Works

    Site establishment; and

    Modification works at APM depot.

Airport Support Infrastructure & Logistic Works:

Contract 3801 APM and BHS Tunnels on Existing Airport Island

    Site establishment;

    Cofferdam installation and construction of box culvert;

    Rising main installation;

    Drilling and grouting works;

    Piling and foundation works

    Demolition works; and

    Site clearance.

Summary Table

The following table summarizes the key findings of the EM&A programme during the reporting period:

Yes

No

Details

Analysis / Recommendation / Remedial Actions

Breach of Limit Level^

No breach of Limit Level was recorded.

Nil

Breach of Action Level^

No breach of Action Level was recorded.

Nil

Complaint Received

No construction activities-related complaint was received

Nil

Notification of any summons and status of prosecutions

No notification of summons or prosecution was received.

Nil

Change that affect the EM&A

There was no change to the construction works that may affect the EM&A

Nil

Note:

^ Only triggering of Action or Limit Level found related to Project works is counted as Breach of Action or Limit Level.

1        Introduction

1.1         Background

On 7 November 2014, the Environmental Impact Assessment (EIA) Report (Register No.: AEIAR-185/2014) for the “Expansion of Hong Kong International Airport into a Three-Runway System” (the Project) was approved and an Environmental Permit (EP) (Permit No.: EP-489/2014) was issued for the construction and operation of the Project.

Airport Authority Hong Kong (AAHK) commissioned Mott MacDonald Hong Kong Limited (MMHK) to undertake the role of Environmental Team (ET) for carrying out the Environmental Monitoring & Audit (EM&A) works during the construction phase of the Project in accordance with the Updated EM&A Manual (the Manual) submitted under EP Condition 3.1. AECOM Asia Company Limited (AECOM) was employed by AAHK as the Independent Environmental Checker (IEC) for the Project.

The Project covers the expansion of the existing airport into a three-runway system (3RS) with key project components comprising land formation of about 650 ha and all associated facilities and infrastructure including taxiways, aprons, aircraft stands, a passenger concourse, an expanded Terminal 2, all related airside and landside works and associated ancillary and supporting facilities. The submarine aviation fuel pipelines and submarine power cables also require diversion as part of the works.

Construction of the Project is to proceed in the general order of diversion of the submarine aviation fuel pipelines, diversion of the submarine power cables, land formation, and construction of infrastructure, followed by construction of superstructures.

The updated overall phasing programme of all construction works was presented in Appendix A of the Construction Phase Monthly EM&A Report No. 7 and the contract information was presented in Appendix A of the Construction Phase Monthly EM&A Report No. 42.

1.2         Scope of this Report

This is the 43rd Construction Phase Monthly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 to 31 July 2019.

1.3         Project Organisation

The Project’s organization structure presented in Appendix B of the Construction Phase Monthly EM&A Report No.1 remained unchanged during the reporting period. Contact details of the key personnel are presented in Table 1.1.

Table 1.1: Contact Information of Key Personnel

Party

Position

Name

Telephone

Project Manager’s Representative

(Airport Authority Hong Kong)

Principal Manager, Environment

Lawrence Tsui

2183 2734

Environmental Team (ET)

(Mott MacDonald Hong Kong Limited)

Environmental Team Leader

Terence Kong

2828 5919

Deputy Environmental Team Leader

Heidi Yu

2828 5704

Deputy Environmental Team Leader

Daniel Sum

2585 8495

Independent Environmental Checker (IEC)

(AECOM Asia Company Limited)

Independent Environmental Checker

Jackel Law

3922 9376

Deputy Independent Environmental Checker

Roy Man

3922 9141

Advanced Works:

Party

Position

Name

Telephone

Contract P560(R) Aviation Fuel Pipeline Diversion Works

(Langfang Huayuan Mechanical and Electrical Engineering Co., Ltd.)

Project Manager

Wei Shih

2117 0566

Environmental Officer

Lyn Liu

5172 6543

Deep Cement Mixing (DCM) Works:

Party

Position

Name

Telephone

Contract 3201 DCM (Package 1)

(Penta-Ocean-China State-Dong-Ah Joint Venture)

Project Director

Tsugunari Suzuki

9178 9689

Environmental Officer

Hiu Yeung Tang

6329 3513

Contract 3202 DCM (Package 2)

(Samsung-BuildKing Joint Venture)

Project Manager

Ilkwon Nam

9643 3117

Contract 3203 DCM  (Package 3)

(Sambo E&C Co., Ltd)

Project Manager

Eric Kan

9014 6758

Contract 3204 DCM  (Package 4)

(CRBC-SAMBO Joint Venture)

Project Manager

Kyung-Sik Yoo

9683 8697

Contract 3205 DCM (Package 5)

(Bachy Soletanche - Sambo Joint Venture)

Deputy Project Director

Min Park

9683 0765

Environmental Officer

Lawrence Chan

5107 5961

Reclamation Works:

Party

Position

Name

Telephone

Contract 3206 Main Reclamation Works

(ZHEC-CCCC-CDC Joint Venture)

Project Manager

Kim Chuan Lim

3763 1509

Environmental Officer

Kwai Fung Wong

3763 1452

Airfield Works:

Party

Position

Name

Telephone

Contract 3301 North Runway Crossover Taxiway (FJT-CHEC-ZHEC Joint Venture)

Deputy Project Director

Kin Hang Chung

9800 0048

Environmental Officer

Nelson Tam

9721 3942

Contract 3302 Eastern Vehicular Tunnel Advance Works

(China Road and Bridge Corporation)

Project Manager

Wan Cheung Lee

6100 6075

Environmental Officer

Wilmer Ng

3919 9421

Contract 3303 Third Runway and Associated Works

(SAPR Joint Venture)

Project Manager

Steven Meredith

6109 1813

Environmental Officer

Pan Fong

9436 9435

Third Runway Concourse and Integrated Airport Centres Works:

Party

Position

Name

Telephone

Contract 3402 New Integrated Airport Centres Enabling Works

(Wing Hing Construction Co., Ltd.)

Contract Manager

Michael Kan

9206 0550

Environmental Officer

Lisa He

5374 3418

Terminal 2 (T2) Expansion Works:

Party

Position

Name

Telephone

Contract 3501 Antenna Farm and Sewage Pumping Station

(Build King Construction Ltd.)

Project Manager

Vincent Kwan

9833 1313

Environmental Officer

Edward Tam

9287 8270

Contract 3502 Terminal 2 APM Depot Modification Works

(Build King Construction Ltd.)

Project Manager

David Ng

9010 7871

Environmental Officer

Chun Pong Chan

9187 7118

Contract 3503 Terminal 2 Foundation and Substructure Works

(Leighton – Chun Wo Joint Venture)

Project Manager

Eric Wu

3973 1718

Environmental Officer

Stephen Tsang

5508 6361

Automated People Mover (APM) Works:

Party

Position

Name

Telephone

Contract 3602 Existing APM System Modification Works

(Niigata Transys Co., Ltd.)

Project Manager

Kunihiro Tatecho

9755 0351

Environmental Officer

Arthur Wong

9170 3394

Baggage Handling System (BHS) Works:

Party

Position

Name

Telephone

Contract 3603 3RS Baggage Handling System (VISH Consortium)

Project Manager

Andy Ng

9102 2739

Environmental Officer

Eric Ha

9215 3432

Airport Support Infrastructure and Logistic Works:

Party

Position

Name

Telephone

Contract 3801 APM and BHS Tunnels on Existing Airport Island

(China State Construction Engineering (Hong Kong) Ltd.)

Project Manager

Tony Wong

9642 8672

Environmental Officer

Fredrick Wong

9842 2703

1.4         Summary of Construction Works

The key activities of the Project carried out in the reporting period included reclamation works and land-side works. Reclamation works included deep cement mixing (DCM) works, marine filling, and seawall construction. Land-side works involved mainly airfield works, foundation and substructure work for Terminal 2 expansion, modification and tunnel work for Automated People Mover (APM) and Baggage Handling System (BHS) systems, and preparation work for utilities, with activities include site establishment, site office construction, road and drainage works, cable ducting, demolition of existing facilities, piling, and excavation works.

The locations of key construction activities are presented in Figure 1.1. Latest layout of the enhanced silt curtain deployed is presented in Figure 1.2.

1.5         Summary of EM&A Programme Requirements

The status for all environmental aspects are presented in Table 1.2. The EM&A requirements remained unchanged during the reporting period and details can be referred to Table 1.2 of the Construction Phase Monthly EM&A Report No. 1.

Table 1.2: Summary of status for all environmental aspects under the Updated EM&A Manual

Parameters

Status

Air Quality

Baseline Monitoring

The baseline air quality monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4.

Impact Monitoring

On-going

Noise

Baseline Monitoring

The baseline noise monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4.

Impact Monitoring

On-going

Water Quality

General Baseline Water Quality Monitoring for reclamation, water jetting and field joint works

The baseline water quality monitoring result has been reported in Baseline Water Quality Monitoring Report and submitted to EPD under EP Condition

3.4.

General Impact Water Quality Monitoring for reclamation, water jetting and field joint works

On-going

Initial Intensive Deep Cement Mixing (DCM) Water Quality Monitoring

The Initial Intensive DCM Monitoring Report was submitted and approved by EPD in accordance with the Detailed Plan on DCM.

Regular DCM Water Quality Monitoring

On-going

Waste Management

Waste Monitoring

On-going

Land Contamination

Supplementary Contamination Assessment Plan (CAP)

The Supplementary CAP was submitted to EPD pursuant to EP Condition 2.20.

Contamination Assessment Report (CAR) for Golf Course

The CAR for Golf Course was submitted to EPD.

Terrestrial Ecology

Pre-construction Egretry Survey Plan

The Egretry Survey Plan was submitted and approved by EPD under EP Condition 2.14.

Ecological Monitoring

The terrestrial ecological monitoring at Sheung Sha Chau was completed in January 2019.

Marine Ecology

Pre-Construction Phase Coral Dive Survey

The Coral Translocation Plan was submitted and approved by EPD under EP Condition 2.12.

Coral Translocation

The coral translocation was completed.

Post-Translocation Coral Monitoring

The post-translocation monitoring programme according to the Coral Translocation Plan was completed in April 2018.

Chinese White Dolphins (CWD)

Vessel Survey, Land-based Theodolite Tracking and Passive Acoustic Monitoring (PAM)

Baseline Monitoring

Baseline CWD results were reported in the CWD Baseline Monitoring Report and submitted to EPD in accordance with EP Condition 3.4.

Impact Monitoring

On-going

Landscape & Visual

Landscape & Visual Plan

The Landscape & Visual Plan was submitted to EPD under EP Condition 2.18

Baseline Monitoring

The baseline landscape & visual monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4.

Impact Monitoring

On-going

Environmental Auditing

Regular site inspection

On-going

Marine Mammal Watching Plan (MMWP) implementation measures

On-going

Dolphin Exclusion Zone (DEZ) Plan implementation measures

On-going

SkyPier High Speed Ferries (HSF) implementation measures

On-going

Construction and Associated Vessels Implementation measures

On-going

Complaint Hotline and Email channel

On-going

Environmental Log Book

On-going

Taking into account the construction works in this reporting period, impact monitoring of air quality, noise, water quality, waste management, landscape & visual, and CWD were carried out in the reporting period.

The EM&A programme also involved weekly site inspections and related auditing conducted by the ET for checking the implementation of the required environmental mitigation measures recommended in the approved EIA Report. To promote the environmental awareness and enhance the environmental performance of the contractors, environmental trainings and regular environmental management meetings were conducted during the reporting period, which are summarized as below:

    Eight environmental management meetings for EM&A review with works contracts: 17, 23, 24, 26, 29, and 30 July 2019

The EM&A programme has been following the recommendations presented in the approved EIA Report and the Manual. A summary of implementation status of the environmental mitigation measures for the construction phase of the Project during the reporting period is provided in Appendix A.

2        Air Quality Monitoring

Air quality monitoring of 1-hour Total Suspended Particulates (TSP) was conducted three times every six days at two representative monitoring stations in the vicinity of air sensitive receivers in Tung Chung and villages in North Lantau in accordance with the Manual. Table 2.1 describes the details of the monitoring stations. Figure 2.1 shows the locations of the monitoring stations.

Table 2.1:  Locations of Impact Air Quality Monitoring Stations

Monitoring Station

Location

AR1A

Man Tung Road Park

AR2

Village House at Tin Sum

2.1         Action and Limit Levels

In accordance with the Manual, baseline air quality monitoring of 1-hour TSP levels at the two air quality monitoring stations were established as presented in the Baseline Monitoring Report. The Action and Limit Levels of the air quality monitoring stipulated in the EM&A programme for triggering the relevant investigation and follow-up procedures under the programme are provided in Table 2.2.

Table 2.2:  Action and Limit Levels of Air Quality Monitoring

Monitoring Station

Action Level (mg/m3)

Limit Level (mg/m3)

AR1A

306

500

AR2

298

2.2         Monitoring Equipment

Portable direct reading dust meter was used to carry out the air quality monitoring. Details of equipment used in the reporting period are given in Table 2.3.

Table 2.3:  Air Quality Monitoring Equipment

Equipment

Brand and Model

Last Calibration Date

Calibration Certificate Provided in

Portable direct reading dust meter (Laser dust monitor)

SIBATA LD-3B-1
(Serial No. 597337)

2 Oct 2018

Monthly EM&A Report No. 35, Appendix D

SIBATA LD-3B-2     (Serial No. 296098)

16 Oct 2018

2.3         Monitoring Methodology

2.3.1      Measuring Procedure

The measurement procedures involved in the impact air quality monitoring can be summarised as follows:

a.   The portable direct reading dust meter was mounted on a tripod at a height of 1.2 m above the ground.

b.   Prior to the measurement, the equipment was set up for 1 minute span check and 6 second background check.

c.   The one hour dust measurement was started. Site conditions and dust sources at the nearby area were recorded on a record sheet.

d.   When the measurement completed, the “Count” reading per hour was recorded for result calculation.

2.3.2      Maintenance and Calibration

The portable direct reading dust meter is calibrated every year against high volume sampler (HVS) to check the validity and accuracy of the results measured by direct reading method. The calibration record of the HVS provided in Appendix D of the Construction Phase Monthly EM&A Report No. 35, and the calibration certificates of portable direct reading dust meters listed in Table 2.3 are still valid.

2.4         Summary of Monitoring Results

The air quality monitoring schedule involved in the reporting period is provided in Appendix B. Due to malfunction of monitoring equipment, the air quality session on 2 July 2019 was rescheduled to 3 July 2019. Besides, the air quality monitoring session on 31 July 2019 was rescheduled to 2 August 2019 due to Strong Wind Signal No. 3 in force.

The air quality monitoring results in the reporting period are summarized in Table 2.4. Detailed impact monitoring results are presented in Appendix C.

Table 2.4: Summary of Air Quality Monitoring Results

Monitoring Station

1-hr TSP Concentration Range (mg/m3)

Action Level (mg/m3)

Limit Level (mg/m3)

AR1A

11 – 65

306

500

AR2

9 – 45

298

The monitoring results were within the corresponding Action and Limit Levels at all monitoring stations in the reporting period.

General meteorological conditions throughout the impact monitoring period were recorded. Wind data including wind speed and wind direction for each monitoring day were collected from the Chek Lap Kok Wind Station.

2.5         Conclusion

No dust emission source from Project activities was observed during impact air quality monitoring. No major sources of dust was observed at the monitoring stations during the monitoring sessions. It is considered that the monitoring work in the reporting period is effective and there was no adverse impact attributable to the Project activities.

3        Noise Monitoring

Noise monitoring in the form of 30-minute measurements of Leq, L10, and L90 levels was conducted once per week between 0700 and 1900 on normal weekdays at four representative monitoring stations in the vicinity of noise sensitive receivers in Tung Chung and villages in North Lantau in accordance with the Manual. Table 3.1 describes the details of the monitoring stations. Figure 2.1 shows the locations of the monitoring stations.

Table 3.1: Locations of Impact Noise Monitoring Stations

Monitoring Station

Location

Type of measurement

NM1A

Man Tung Road Park

Free field

NM2(1)

Tung Chung West Development

To be determined

NM3A(2)

Site Office

Facade

NM4

Ching Chung Hau Po Woon Primary School

Free field

NM5

Village House in Tin Sum

Free field

NM6

House No. 1, Sha Lo Wan

Free field

Note:

(1)    As described in Section 4.3.3 of the Manual, noise monitoring at NM2 will only commence after occupation of the future Tung Chung West Development.

(2)    According to Section 4.3.3 of the Manual, the noise monitoring at NM3A was temporarily suspended starting from 1 Sep 2018 and would be resumed with the completion of the Tung Chung East Development.

3.1         Action and Limit Levels

In accordance with the Manual, baseline noise levels at the noise monitoring stations were established as presented in the Baseline Monitoring Report. The Action and Limit Levels of the noise monitoring stipulated in the EM&A programme for triggering the relevant investigation and follow-up procedures under the programme are provided in Table 3.2.

Table 3.2: Action and Limit Levels for Noise Monitoring

Monitoring Stations

Time Period

Action Level

Limit Level, Leq(30mins) dB(A)

NM1A, NM2, NM3A, NM4, NM5 and NM6

0700-1900 hours on normal weekdays

When one documented

complaint is received from

any one of the sensitive

receivers

75 dB(A)(1)

Note:

(1)     Reduced to 70dB(A) for school and 65dB(A) during school examination periods for NM4.

3.2         Monitoring Equipment

Noise monitoring was performed using sound level meter at each designated monitoring station.  The sound level meters deployed comply with the International Electrotechnical Commission Publications 651:1979 (Type 1) and 804:1985 (Type 1) specifications. Acoustic calibrator was used to check the sound level meters by a known sound pressure level for field measurement.  Details of equipment used in the reporting period are given in Table 3.3.

Table 3.3: Noise Monitoring Equipment

Equipment

Brand and Model

Last Calibration Date

Calibration Certificate Provided in

Integrated Sound Level Meter

Rion NL-52

(Serial No. 01287679)

6 Feb 2019

Monthly EM&A Report No. 39, Appendix D

NTi XL2

(Serial No. A2A-14829-E0)

14 July 2019

Appendix D

Acoustic Calibrator

Casella CEL-120/1 (Serial No. 2383737)

17 Oct 2018

Monthly EM&A Report No. 35, Appendix D

Castle GA607 (Serial No. 040162)

14 July 2019

Appendix D

3.3         Monitoring Methodology

3.3.1      Monitoring Procedure

The monitoring procedures involved in the noise monitoring can be summarised as follows:

a.   The sound level meter was set on a tripod at least a height of 1.2 m above the ground for free-field measurements at monitoring stations NM1A, NM4, NM5 and NM6. A correction of +3 dB(A) was applied to the free field measurements.

b.   Façade measurements were made at the monitoring station NM3A.

c.   Parameters such as frequency weighting, time weighting and measurement time were set.

d.   Prior to and after each noise measurement, the meter was calibrated using the acoustic calibrator.  If the difference in the calibration level before and after measurement was more than 1 dB(A), the measurement would be considered invalid and repeat of noise measurement would be required after re-calibration or repair of the equipment.

e.   During the monitoring period, Leq, L10 and L90 were recorded.  In addition, site conditions and noise sources were recorded on a record sheet.

f.    Noise measurement results were corrected with reference to the baseline monitoring levels.

g.   Observations were recorded when high intrusive noise (e.g. dog barking, helicopter noise) was observed during the monitoring.

3.3.2      Maintenance and Calibration

The maintenance and calibration procedures are summarised below:

a.   The microphone head of the sound level meter was cleaned with soft cloth at regular intervals.

b.   The meter and calibrator were sent to the supplier or laboratory accredited under Hong Kong Laboratory Accreditation Scheme (HOKLAS) to check and calibrate at yearly intervals.

Calibration certificates of the sound level meters and acoustic calibrators used in the noise monitoring listed in Table 3.3 are still valid.

3.4         Summary of Monitoring Results

The noise monitoring schedule involved in the reporting period is provided in Appendix B.

The noise monitoring results in the reporting period are summarized in Table 3.4. Detailed impact monitoring results are presented in Appendix C.

Table 3.4: Summary of Construction Noise Monitoring Results

Monitoring Station

Noise Level Range, dB(A)

Leq (30 mins)

Limit Level, dB(A)

Leq (30 mins)

NM1A(1)

72 – 73

75

NM4(1)

60 – 63

70(2)

NM5(1)

59 – 62

75

NM6(1)

67 – 70

75

Notes:

(1)    +3 dB(A) Façade correction included;

(2)    Reduced to 65 dB(A) during school examination periods at NM4. No school examination took place during this reporting period.

No complaints were received from any sensitive receiver that triggered the Action Level. All monitoring results were also within the corresponding Limit Levels at all monitoring stations in the reporting period.

3.5         Conclusion

As the construction activities were far away from the monitoring stations, major sources of noise dominating the monitoring stations observed during the construction noise impact monitoring were traffic noise near NM1A, aircraft and helicopter noise near NM5 and NM6 during this reporting period. It is considered that the monitoring work during the reporting period was effective and there was no adverse impact attributable to the Project activities.

4        Water Quality Monitoring

Water quality monitoring of DO, pH, temperature, salinity, turbidity, suspended solids (SS), total alkalinity, chromium, and nickel was conducted three days per week, at mid-ebb and mid-flood tides, at a total of 23 water quality monitoring stations, comprising 12 impact (IM) stations, 8 sensitive receiver (SR) stations and 3 control (C) stations in the vicinity of water quality sensitive receivers around the airport island in accordance with the Manual. The purpose of water quality monitoring at the IM stations is to promptly capture any potential water quality impact from the Project before it could become apparent at sensitive receivers (represented by the SR stations). Table 4.1 describes the details of the monitoring stations. Figure 4.1 shows the locations of the monitoring stations.

Table 4.1: Monitoring Locations and Parameters of Impact Water Quality Monitoring

Monitoring Station

Description

Coordinates

Parameters

Easting

Northing

C1

Control Station

804247

815620

General Parameters

DO, pH, Temperature, Salinity, Turbidity, SS

DCM Parameters

Total Alkalinity, Heavy Metals(2)

C2

Control Station

806945

825682

C3(3)

Control Station

817803

822109

IM1

Impact Station

807132

817949

IM2

Impact Station

806166

818163

IM3

Impact Station

805594

818784

IM4

Impact Station

804607

819725

IM5

Impact Station

804867

820735

IM6

Impact Station

805828

821060

IM7

Impact Station

806835

821349

IM8

Impact Station

808140

821830

IM9

Impact Station

808811

822094

IM10

Impact Station

809794

822385

IM11

Impact Station

811460

822057

IM12

Impact Station

812046

821459

SR1A(1)

Hong Kong-Zhuhai-Macao Bridge Hong Kong Boundary Crossing Facilities (HKBCF) Seawater Intake for cooling

812660

819977

General Parameters

DO, pH, Temperature, Salinity, Turbidity, SS

SR2(3)

Planned marine park / hard corals at The Brothers / Tai Mo To

814166

821463

General Parameters

DO, pH, Temperature, Salinity, Turbidity, SS

DCM Parameters

Total Alkalinity, Heavy Metals(2)(4)

SR3

Sha Chau and Lung Kwu Chau Marine Park / fishing and spawning grounds in North Lantau

807571

822147

General Parameters

DO, pH, Temperature, Salinity, Turbidity, SS

SR4A

Sha Lo Wan

807810

817189

SR5A

San Tau Beach SSSI

810696

816593

SR6

Tai Ho Bay, Near Tai Ho Stream SSSI

814663

817899

SR7

Ma Wan Fish Culture Zone (FCZ)

823742

823636

SR8(5)

Seawater Intake for cooling at Hong Kong International Airport (East)

811623

820390

Notes:

(1)    With the operation of HKBCF, water quality monitoring at SR1A station was commenced on 25 October 2018. To better reflect the water quality in the immediate vicinity of the intake, the monitoring location of SR1A has been shifted closer to the intake starting from 5 January 2019.

(2)    Details of selection criteria for the two heavy metals for regular DCM monitoring refer to the Detailed Plan on Deep Cement Mixing available on the dedicated 3RS website (http://env.threerunwaysystem.com/en/ep-submissions.html).  DCM specific water quality monitoring parameters (total alkalinity and heavy metals) were only conducted at C1 to C3, SR2, and IM1 to IM12.

(3)    According to the Baseline Water Quality Monitoring Report, C3 station is not adequately representative as a control station of impact/ SR stations during the flood tide. The control reference has been changed from C3 to SR2 from 1 September 2016 onwards.

(4)    Total alkalinity and heavy metals results are collected at SR2 as a control station for regular DCM monitoring.

(5)    The monitoring location for SR8 is subject to further changes due to silt curtain arrangements and the progressive relocation of this seawater intake.

4.1      Action and Limit Levels

In accordance with the Manual, baseline water quality levels at the abovementioned representative water quality monitoring stations were established as presented in the Baseline Water Quality Monitoring Report. The Action and Limit Levels of general water quality monitoring and regular DCM monitoring stipulated in the EM&A programme for triggering the relevant investigation and follow-up procedures under the programme are provided in Table 4.2. The control and impact stations during ebb tide and flood tide for general water quality monitoring and regular DCM monitoring are presented in Table 4.3.

Table 4.2: Action and Limit Levels for General Water Quality Monitoring and Regular DCM Monitoring

Parameters

Action Level (AL)

Limit Level (LL)

Action and Limit Levels for general water quality monitoring and regular DCM monitoring

(excluding SR1A & SR8)

General Water Quality Monitoring

DO in mg/L (Surface, Middle & Bottom)

Surface and Middle

4.5 mg/L

Surface and Middle

4.1 mg/L

5 mg/L for Fish Culture Zone (SR7) only

Bottom

3.4 mg/L

Bottom

2.7 mg/L

Suspended Solids (SS) in mg/L

23

or 120% of upstream control station at the same tide of the same day, whichever is higher

37

or 130% of upstream control station at the same tide of the same day, whichever is higher

Turbidity in NTU

22.6

36.1

Regular DCM Monitoring

Total Alkalinity in ppm

95

99

Representative Heavy Metals for regular DCM monitoring (Chromium) in µg/L

0.2

0.2

Representative Heavy Metals for regular DCM monitoring (Nickel) in µg/L

3.2

3.6

Action and Limit Levels SR1A

SS (mg/l)

33

42

Action and Limit Levels SR8

SS (mg/l)

52

60

Notes:

(1)    For DO measurement, non-compliance occurs when monitoring result is lower than the limits.

(2)    For parameters other than DO, non-compliance of water quality results when monitoring results is higher than the limits.

(3)    Depth-averaged results are used unless specified otherwise.

(4)    Details of selection criteria for the two heavy metals for regular DCM monitoring refer to the Detailed Plan on Deep Cement Mixing available on the dedicated 3RS website (http://env.threerunwaysystem.com/en/ep-submissions.html)

(5)    The Action and Limit Levels for the two representative heavy metals chosen will be the same as that for the intensive DCM monitoring.

Table 4.3: The Control and Impact Stations during Flood Tide and Ebb Tide for General Water Quality Monitoring and Regular DCM Monitoring

Control Station

Impact Stations

Flood Tide

C1

IM1, IM2, IM3, IM4, IM5, IM6, IM7, IM8, SR3

SR2(1)

IM7, IM8, IM9, IM10, IM11, IM12, SR1A, SR3, SR4A, SR5A, SR6, SR8

Ebb Tide

C1

SR4A, SR5A, SR6

C2

IM1, IM2, IM3, IM4, IM5, IM6, IM7, IM8, IM9, IM10, IM11, IM12, SR1A, SR2, SR3, SR7, SR8

Note:

(1)    As per findings of Baseline Water Quality Monitoring Report, the control reference has been changed from C3 to SR2 from 1 Sep 2016 onwards.

4.2         Monitoring Equipment

Table 4.4 summarises the equipment used in the reporting period for monitoring of specific water quality parameters under the water quality monitoring programme.

Table 4.4: Water Quality Monitoring Equipment

Equipment

Brand and Model

Last Calibration Date

Calibration Certificate Provided in

Multifunctional Meter (measurement of DO, pH, temperature, salinity and turbidity)

YSI ProDSS (Serial No. 17H105557)(1)

30 Apr 2019

Monthly EM&A Report No. 41, Appendix D

YSI ProDSS (Serial No. 16H104233)(1)

30 Apr 2019

YSI ProDSS (Serial No. 16H104234)(1)

30 Apr 2019

YSI ProDSS (Serial No. 17E100747)

25 Jun 2019

Monthly EM&A Report No. 42, Appendix E

YSI ProDSS (Serial No. 15M100005)

25 Jun 2019

YSI 6920V2 (Serial No. 0001C6A7)

24 July 2019

Appendix D

YSI 6920V2 (Serial No. 00019CB2)

24 July 2019

Digital Titrator (measurement of total alkalinity)

Titrette Digital Burette 50ml Class A

(Serial No. 10N65665)

20 May 2019

Monthly EM&A Report No. 41, Appendix D

Note:

(1)    The monitoring equipment was not used in the reporting period after the expiry date of the calibration certificate.

Other equipment used as part of the impact water quality monitoring programme are listed in Table 4.5.

Table 4.5: Other Monitoring Equipment

Equipment

Brand and Model

Water Sampler

Van Dorn Water Sampler

Positioning Device (measurement of GPS)

Garmin eTrex Vista HCx

Current Meter (measurement of current speed and direction, and water depth)

Sontek HydroSurveyor

4.3         Monitoring Methodology

4.3.1      Measuring Procedure

Water quality monitoring samples were taken at three depths (at 1m below surface, at mid-depth, and at 1m above bottom) for locations with water depth >6m. For locations with water depth between 3m and 6m, water samples were taken at two depths (surface and bottom). For locations with water depth <3m, only the mid-depth was taken. Duplicate water samples were taken and analysed.

The water samples for all monitoring parameters were collected, stored, preserved and analysed according to the Standard Methods, APHA 22nd ed. and/or other methods as agreed by the EPD. In-situ measurements at monitoring locations including temperature, pH, DO, turbidity, salinity, alkalinity and water depth were collected by equipment listed in Table 4.4 and Table 4.5. Water samples for heavy metals and SS analysis were stored in high density polythene bottles with no preservative added, packed in ice (cooled to 4 ºC without being frozen), delivered to the laboratory within 24 hours of collection.

4.3.2      Maintenance and Calibration

Calibration of In-situ Instruments

All in-situ monitoring instrument were checked, calibrated and certified by a laboratory accredited under HOKLAS before use. Responses of sensors and electrodes were checked with certified standard solutions before each use.

Wet bulb calibration for a DO meter was carried out before commencement of monitoring and after completion of all measurements each day. Calibration was not conducted at each monitoring location as daily calibration is adequate for the type of DO meter employed. A zero check in distilled water was performed with the turbidity probe at least once per monitoring day. The probe was then calibrated with a solution of known NTU. In addition, the turbidity probe was calibrated at least twice per month to establish the relationship between turbidity readings (in NTU) and levels of SS (in mg/L).  Accuracy check of the digital titrator was performed at least once per monitoring day.

Calibration certificates of the monitoring equipment used in the reporting period listed in Table 4.4 are still valid.

4.3.3      Laboratory Measurement / Analysis

Analysis of SS and heavy metals have been carried out by a HOKLAS accredited laboratory, ALS Technichem (HK) Pty Ltd (Reg. No. HOKLAS 066). Sufficient water samples were collected at all the monitoring stations for carrying out the laboratory SS and heavy metals determination. The SS and heavy metals determination works were started within 24 hours after collection of the water samples. The analysis of SS and heavy metals have followed the standard methods summarised in Table 4.6. The QA/QC procedures for laboratory measurement/ analysis of SS and heavy metals were presented in Appendix F of the Construction Phase Monthly EM&A Report No.8.

Table 4.6: Laboratory Measurement/ Analysis of SS and Heavy Metals

Parameters

Instrumentation

Analytical Method

Reporting Limit

SS

Analytical Balance

APHA 2540D

2 mg/L

Heavy Metals

Chromium (Cr)

ICP-MS

USEPA 6020A

0.2 µg/L

Nickel (Ni)

ICP-MS

USEPA 6020A

0.2 µg/L

4.4         Summary of Monitoring Results

The water quality monitoring schedule for the reporting period is updated and provided in Appendix B.

The water quality monitoring results for turbidity, SS, total alkalinity, chromium, and nickel obtained during the reporting period were within their corresponding Action and Limit Level. The detailed monitoring results are presented in Appendix C.

For DO, some of the testing results triggered the corresponding Action or Limit Levels, and investigations were conducted accordingly.

Table 4.7 to Table 4.10 present summaries of the DO compliance status at IM and SR stations during mid-ebb and mid-flood tide for the reporting period.

Table 4.7: Summary of DO (Surface and Middle) Compliance Status (Mid-Ebb Tide)

Table 4.8: Summary of DO (Bottom) Compliance Status (Mid-Ebb Tide)

Table 4.9: Summary of DO (Surface and Middle) Compliance Status (Mid-Flood Tide)

Table 4.10: Summary of DO (Bottom) Compliance Status (Mid-Flood Tide)

Note: Detailed results are presented in Appendix C.

Legend:

The monitoring results were within the corresponding Action and Limit Levels

Monitoring result triggered the Action Level at monitoring station located upstream of the Project based on dominant tidal flow

D

Monitoring result triggered the Action Level at monitoring station located downstream of the Project based on dominant tidal flow

Monitoring result triggered the Limit Level at monitoring station located upstream of the Project based on dominant tidal flow

D

Monitoring result triggered the Limit Level at monitoring station located downstream of the Project based on dominant tidal flow

Upstream station with respect to the Project during the respective tide based on dominant tidal flow

Monitoring results triggered the corresponding Action and Limit Levels on three monitoring days. Repeat measurement were conducted on 12, 14 and 28 July 2019 respectively according to the Manual. Some cases occurred at monitoring stations upstream of the Project during respective tide and would unlikely be affected by the Project. Investigation was therefore focused on cases that occurred at monitoring station located downstream of the Project. Details of the Project’s marine construction activities and site observations on the concerned monitoring days were collected. The findings are summarized in Table 4.11.

Table 4.11: Summary of Findings from Investigation of DO Monitoring Results

Date

Marine construction works nearby

Approximate distance from marine construction works

Status of water quality measures (if applicable)

Construction vessels in the vicinity

Turbidity / Silt plume observed near the monitoring station

Action or Limit Level triggered due to Project

11/07/2019

Marine filling and DCM works

Around

1 km

Localised and enhanced silt curtain deployed

No

No

No

13/07/2019

Marine filling and DCM works

Around

1 km

Localised and enhanced silt curtain deployed

No

No

No

27/07/2019

Marine filling and DCM works

Around

1 km

Localised and enhanced silt curtain deployed

No

No

No

The investigation confirmed that DCM works and marine filling were operating normally with localised and enhanced silt curtain deployed. The localised and enhanced silt curtains were maintained properly and checked by ET regularly.

On 11 and 13 July 2019, it was noted that the DO concentrations recorded at most of the impact and sensitive stations were within their baseline ranges and were also similar to, if not higher than their respective control station. During the same tide, DO Action and Limit Levels were also triggered at adjacent upstream monitoring stations. These suggested the presence of external sources in the upstream areas that might affect the water quality around the Project Area. With no silt plume observed at the monitoring stations and mitigation measures implemented properly, the cases recorded at these impact and sensitive receiver stations were considered not due to the Project.

On 27 July 2019, it was found that the DO concentrations at IM2, IM3, IM4 and SR4A were within their corresponding baseline ranges during baseline monitoring of the Project. For SR7, no Action or Limit Level was triggered at downstream impact stations located closer to the Project Area, namely IM11 and IM12. These suggested the stations were potentially affected by external sources. With no silt plume observed at the monitoring stations and mitigation measures implemented properly, the cases recorded at these impact and sensitive receiver stations were considered not caused by the Project.

4.5         Conclusion

During the reporting period, it is noted that the vast majority of monitoring results were within their corresponding Action and Limit Levels, while only a minor number of results triggered the corresponding Action and Limit Levels, and investigations were conducted accordingly.

Based on the investigation findings, all results that triggered the corresponding Action or Limit Levels were not due to the Project. Therefore, the Project did not cause adverse impact at the water quality sensitive receivers. All required actions under the Event and Action Plan were followed. These cases appeared to be due to natural fluctuation or other sources not related to the Project.

Nevertheless, as part of the EM&A programme, the construction methods and mitigation measures for water quality will continue to be monitored and opportunities for further enhancement will continue to be explored and implemented where possible, to strive for better protection of water quality and the marine environment.

In the meantime, the contractors were reminded to implement and maintain all mitigation measures during weekly site inspection and regular environmental management meetings. These include maintaining mitigation measures properly for reclamation works including DCM works, marine filling, and seawall construction as recommended in the Manual.

5        Waste Management

In accordance with the Manual, the waste generated from construction activities was audited once per week to determine if wastes are being managed in accordance with the Waste Management Plan (WMP) prepared for the Project, contract-specific WMP, and any statutory and contractual requirements. All aspects of waste management including waste generation, storage, transportation and disposal were assessed during the audits.

5.1         Action and Limit Levels

The Action and Limit Levels of the construction waste are provided in Table 5.1.

Table 5.1: Action and Limit Levels for Construction Waste

Monitoring Stations

Action Level

Limit Level

Construction Area

When one valid documented complaint is

received

Non-compliance of the WMP, contract-specific

WMPs, any statutory and contractual

requirements

5.2         Waste Management Status

Weekly monitoring on all works contracts were carried out by the ET to check and monitor the implementation of proper waste management practices during the construction phase.

Recommendations made included provision and maintenance of proper chemical waste storage area, as well as handling, segregation, and regular disposal of general refuse. The contractors had taken actions to implement the recommended measures.

Based on updated information provided by contractors, construction waste generated in the reporting period is summarized in Table 5.2.

There were no complaints, non-compliance of the WMP, contract-specific WMPs, statutory and contractual requirements that triggered Action and Limit Levels in the reporting period.

Table 5.2: Construction Waste Statistics

C&D(1) Material Stockpiled for Reuse or Recycle

(m3)

C&D Material Reused in the Project

(m3)

C&D Material Reused in other Projects

(m3)

C&D Material Transferred to Public Fill

(m3)

Chemical Waste

(kg)

Chemical Waste

(L)

General Refuse

(tonne)

June 2019(2)(3)

*9,982

*4,684

*339

5,570

150

15,400

354

July 2019(3)

4,641

4,500

665

4,629

200

9,040

399

Notes:

(1)    C&D refers to Construction and Demolition.

(2)    Updated figures in the past month are reported and marked with an asterisk (*). Updated figures for earlier months will be reported in the forthcoming Annual EM&A Report.

(3)    Metals, paper and/or plastics were recycled in the reporting period.

6        Chinese White Dolphin Monitoring

In accordance with the Manual, CWD monitoring by small vessel line-transect survey supplemented by land-based theodolite tracking survey and passive acoustic monitoring should be conducted during construction phase.

The small vessel line-transect survey should be conducted at a frequency of two full surveys per month, while land-based theodolite tracking survey should be conducted at a frequency of one day per month per station at Sha Chau (SC) and Lung Kwu Chau (LKC) during the construction phase as stipulated in the Manual. Supplemental theodolite tracking survey of one additional day has also been conducted at LKC, i.e. in total twice per month at the LKC station.

6.1         Action and Limit Levels

The Action and Limit Levels for CWD monitoring were formulated by the action response approach using the running quarterly dolphin encounter rates STG and ANI derived from the baseline monitoring data, as presented in the CWD Baseline Monitoring Report. The derived values of Action and Limit Levels for CWD monitoring were summarized in Table 6.1.

Table 6.1: Derived Values of Action and Limit Levels for Chinese White Dolphin Monitoring

NEL, NWL, AW, WL and SWL as a Whole

Action Level(3)

Running quarterly(1) STG < 1.86 & ANI < 9.35

Limit Level(3)

Two consecutive running quarterly(2) (3-month) STG < 1.86 & ANI < 9.35

Notes: (referring to the baseline monitoring report)

(1)    Action Level – running quarterly STG & ANI will be calculated from the three preceding survey months.

(2)    Limit Level – two consecutive running quarters mean both the running quarterly encounter rates of the preceding month and the running quarterly encounter rates of this month.

(3)    Action Level and/or Limit Level will be triggered if both STG and ANI fall below the criteria.

6.2         CWD Monitoring Transects and Stations

6.2.1      Small Vessel Line-transect Survey

Small vessel line-transect surveys were conducted along the transects covering Northeast Lantau (NEL), Northwest Lantau (NWL), Airport West (AW), West Lantau (WL) and Southwest Lantau (SWL) areas as proposed in the Manual, which are consistent with the Agriculture, Fisheries and Conservation Department (AFCD) long-term monitoring programme (except the addition of AW). The AW transect has not been previously surveyed in the AFCD programme due to the restrictions of HKIA Approach Area, nevertheless, this transect was established during the EIA of the 3RS Project and refined in the Manual with the aim to collect project specific baseline information within the HKIA Approach Area to fill the data gap that was not covered by the AFCD programme. This also provided a larger sample size for estimating the density, abundance and patterns of movements in the broader study area of the project.

The planned vessel survey transect lines follow the waypoints set for construction phase monitoring as proposed in the Manual and depicted in Figure 6.1 with the waypoint coordinates of all transect lines given in Table 6.2, which are subject to on-site refinement based on the actual survey conditions and constraints.

Table 6.2: Coordinates of Transect Lines in NEL, NWL, AW, WL and SWL Survey Areas

Waypoint

Easting

Northing

Waypoint

Easting

Northing

NEL

1S

813525

820900

6N

818568

824433

1N

813525

824657

7S

819532

821420

2S

814556

818449

7N

819532

824209

2N

814559

824768

8S

820451

822125

3S

815542

818807

8N

820451

823671

3N

815542

824882

9S

821504

822371

4S

816506

819480

9N

821504

823761

4N

816506

824859

10S

822513

823268

5S

817537

820220

10N

822513

824321

5N

817537

824613

11S

823477

823402

6S

818568

820735

11N

823477

824613

NWL

1S

804671

814577

5S

808504

821735

1N

804671

831404

5N

808504

828602

2Sb

805475

815457

6S

809490

822075

2Nb

805476

818571

6N

809490

825352

2Sa

805476

820770

7S

810499

822323

2Na

805476

830562

7N

810499

824613

3S

806464

821033

8S

811508

821839

3N

806464

829598

8N

811508

824254

4S

807518

821395

9S

812516

821356

4N

807518

829230

9N

812516

824254

AW

1W

804733

818205

2W

805045

816912

1E

806708

818017

2E

805960

816633

WL

1W

800600

805450

7W

800400

811450

1E

801760

805450

7E

802400

811450

2W

800300

806450

8W

800800

812450

2E

801750

806450

8E

802900

812450

3W

799600

807450

9W

801500

813550

3E

801500

807450

9E

803120

813550

4W

799400

808450

10W

801880

814500

4E

801430

808450

10E

803700

814500

5W

799500

809450

11W

802860

815500

5E

801300

809450

12S/11E

803750

815500

6W

799800

810450

12N

803750

818500

6E

801400

810450

SWL

1S

802494

803961

6S

807467

801137

1N

802494

806174

6N

807467

808458

2S

803489

803280

7S

808553

800329

2N

803489

806720

7N

808553

807377

3S

804484

802509

8S

809547

800338

3N

804484

807048

8N

809547

807396

4S

805478

802105

9S

810542

800423

4N

805478

807556

9N

810542

807462

5S

806473

801250

10S

811446

801335

5N

806473

808458

10N

811446

809436

6.2.2      Land-based Theodolite Tracking Survey

Land-based theodolite tracking survey stations were set up at two locations, one facing east/south/west on the southern slopes of Sha Chau (SC), and the other facing north/northeast/northwest at Lung Kwu Chau (LKC). The stations (D and E) are depicted in Figure 6.2 and shown in Table 6.3 with position coordinates, height of station and approximate distance of consistent theodolite tracking capabilities for CWD.

Table 6.3: Land-based Theodolite Survey Station Details

Stations

Location

Geographical Coordinates

Station Height (m)

Approximate Tracking Distance (km)

D

Sha Chau (SC)

22° 20’ 43.5” N

113° 53’ 24.66” E

45.66

2

E

Lung Kwu Chau (LKC)

22° 22’ 44.83” N

113° 53’ 0.2” E

70.40

3

6.3         CWD Monitoring Methodology

6.3.1      Small Vessel Line-transect Survey

Small vessel line-transect surveys provided data for density and abundance estimation and other assessments using distance-sampling methodologies, specifically, line-transect methods.

The surveys involved small vessel line-transect data collection and have been designed to be similar to, and consistent with, previous surveys for the AFCD for their long-term monitoring of small cetaceans in Hong Kong. The survey was designed to provide systematic, quantitative measurements of density, abundance and habitat use.

As mentioned in Section 6.2.1, the transects covered NEL, NWL covering the AW, WL and SWL areas as proposed in the Manual and are consistent with the AFCD long-term monitoring programme (except AW). There are two types of transect lines:

    Primary transect lines: the parallel and zigzag transect lines as shown in Figure 6.1; and

    Secondary transect lines: transect lines connecting between the primary transect lines and going around islands.

All data collected on both primary and secondary transect lines were used for analysis of sighting distribution, group size, activities including association with fishing boat, and mother-calf pairs. Only on-effort data collected under conditions of Beaufort 0-3 and visibility of approximately 1200 m or beyond were used for analysis of the CWD encounter rates.

A 15-20 m vessel with a flying bridge observation platform about 4 to 5 m above water level and unobstructed forward view, and a team of three to four observers were deployed to undertake the surveys.  Two observers were on search effort at all times when following the transect lines with a constant speed of 7 to 8 knots (i.e. 13 to 15 km per hour), one using 7X handheld binoculars and the other using unaided eyes and recording data.

During on-effort survey periods, the survey team recorded effort data including time, position (waypoints), weather conditions (Beaufort sea state and visibility) and distance travelled in each series with assistance of a handheld GPS device. The GPS device also continuously and automatically logged data including time, position (latitude and longitude) and vessel speed throughout the entire survey.

When CWDs were seen, the survey team was taken off-effort, the dolphins were approached and photographed for photo-ID information (using a Canon 7D [or similar] camera and long 300 mm+ telephoto lens), then followed until they were lost from view.  At that point, the boat returned (off effort) to the survey line at the closest point after obtaining photo records of the dolphin group and began to survey on effort again.

Focal follows of dolphins would be used for providing supplementary information only where practicable (i.e. when individual dolphins or small stable groups of dolphins with at least one member that could be readily identifiable with unaided eyes during observations and weather conditions are favourable). These would involve the boat following (at an appropriate distance to minimize disturbance) an identifiable individual dolphin for an extended period of time, and collecting detailed data on its location, behaviour, response to vessels, and associates.

6.3.2      Photo Identification

CWDs can be identified by their unique features like presence of scratches, nick marks, cuts, wounds, deformities of their dorsal fin and distinguished colouration and spotting patterns.

When CWDs were observed, the survey team was taken off-effort, the dolphins were approached and photographed for photo-ID information (using a Canon 7D [or similar] camera and long 300 mm+ telephoto lens). The survey team attempted to photo both sides of every single dolphin in the group as the colouration and spotting pattern on both sides may not be identical. The photos were taken at the highest available resolution and stored on Compact Flash memory cards for transferring into a computer.

All photos taken were initially examined to sort out those containing potentially identifiable individuals. These sorted-out images would then be examined in detail and compared to the CWD photo-identification catalogue established for 3RS during the baseline monitoring stage.

6.3.3      Land-based Theodolite Tracking Survey

Land-based theodolite tracking survey obtains fine-scale information on the time of day and movement patterns of the CWDs.  A digital theodolite (Sokkia/Sokkisha Model DT5 or similar equipment) with 30-power magnification and 5-s precision was used to obtain the vertical and horizontal angle of each dolphin and vessel position. Angles were converted to geographic coordinates (latitude and longitude) and data were recorded using Pythagoras software, Version 1.2. This method delivers precise positions of multiple spatially distant targets in a short period of time.  The technique is fully non-invasive, and allows for time and cost-effective descriptions of dolphin habitat use patterns at all times of daylight.

Three surveyors (one theodolite operator, one computer operator, and one observer) were involved in each survey. Observers searched for dolphins using unaided eyes and handheld binoculars (7X50). Theodolite tracking sessions were initiated whenever an individual CWD or group of CWDs was located.  Where possible, a distinguishable individual was selected, based on colouration, within the group.  The focal individual was then continuously tracked via the theodolite, with a position recorded each time the dolphin surfaced. In case an individual could not be positively distinguished from other members, the group was tracked by recording positions based on a central point within the group whenever the CWD surfaced. Tracking continued until animals were lost from view; moved beyond the range of reliable visibility (>1-3 km, depending on station height); or environmental conditions obstructed visibility (e.g., intense haze, Beaufort sea state >4, or sunset), at which time the research effort was terminated.  In addition to the tracking of CWD, all vessels that moved within 2-3 km of the station were tracked, with effort made to obtain at least two positions for each vessel.

Theodolite tracking included focal follows of CWD groups and vessels. Priority was given to tracking individual or groups of CWD. The survey team also attempted to track all vessels moving within 1 km of the focal CWD.

6.4         Monitoring Results and Observations

6.4.1      Small Vessel Line-transect Survey

Survey Effort

Within this reporting period, two complete sets of small vessel line-transect surveys were conducted on the 8, 9, 16, 17, 18, 22, 23 and 24 July 2019, covering all transects in NEL, NWL, AW, WL and SWL survey areas for twice.

A total of around 444.28 km of survey effort was collected from these surveys, with around 97.2% of the total survey effort being conducted under favourable weather condition (i.e. Beaufort Sea State 3 or below with favourable visibility). Details of the survey effort are given in Appendix D.

Sighting Distribution

In July 2019, 33 sightings with 137 dolphins were sighted. Details of cetacean sightings are presented in Appendix C.

Distribution of all CWD sightings recorded in July 2019 is illustrated in Figure 6.3. In NWL, there were two CWD sightings recorded at the northwestern waters of Lung Kwu Chau and southwestern corner of the survey area respectively. In WL, CWD sightings were recorded from Tai O to Fan Lau with more sightings recorded between Tai O and Peaked Hil. In SWL, there were remarkable increase in CWD sightings compared to previous months. Based on field observation, there were plenty of schools of fish appeared in SWL waters during the surveys in that area. This might be a possible reason for the emerging of a large number of CWDs in SWL in this month. CWD sightings in SWL were scattered among the entire survey area from Fan Lau to the Soko Islands and Lo Kei Wan. No sightings of CWD were recorded in NEL or in close vicinity to 3RS Works Area.

Figure 6.3: Sightings Distribution of Chinese White Dolphins

Remarks: Please note that there are 33 pink circles on the map indicating the sighting locations of CWDs. Some of them were very close to each other and therefore may appear overlapped on this distribution map.

Encounter Rate

Two types of dolphin encounter rates were calculated based on the data from July 2019. They included the number of dolphin sightings per 100 km survey effort (STG) and total number of dolphins per 100 km survey effort (ANI) in the whole survey area (i.e. NEL, NWL, AW, WL and SWL). In the calculation of dolphin encounter rates, only survey data collected under favourable weather condition (i.e. Beaufort Sea State 3 or below with favourable visibility) were used. The formulae used for calculation of the encounter rates are shown below:

Encounter Rate by Number of Dolphin Sightings (STG)

Encounter Rate by Number of Dolphins (ANI)

(Notes:    Only data collected under Beaufort 3 or below condition were used)

In July 2019, a total of around 431.92 km of survey effort were conducted under Beaufort Sea State 3 or below with favourable visibility, whilst a total number of 33 on-effort sightings with 137 dolphins were sighted under such condition. Calculation of the encounter rates in July 2019 are shown in Appendix C.

For the running quarter of the reporting period (i.e., from May 2019 to July 2019), a total of around 1258.50 km of survey effort were conducted under Beaufort Sea State 3 or below with favourable visibility, whilst a total number of 55 on-effort sightings and a total number of 223 dolphins from on-effort sightings were obtained under such condition. Calculation of the running quarterly encounter rates are shown in Appendix C.

The STG and ANI of CWD in the whole survey area (i.e. NEL, NWL, AW, WL and SWL) during the month of July 2019 and during the running quarter are presented in Table 6.4 below and compared with the Action Level. The running quarterly encounter rates STG and ANI did not trigger Action Level.

Table 6.4: Comparison of CWD Encounter Rates of the Whole Survey Area with Action Levels

Encounter Rate (STG)

Encounter Rate (ANI)

July 2019

7.64

31.72

Running Quarter from May 2019 to July 2019(1)

4.37

17.72

Action Level

Running quarterly(1) STG < 1.86 & ANI < 9.35

Note: (1) Running quarterly encounter rates STG & ANI were calculated from data collected in the reporting period and the two preceding survey months, i.e. the data from May 2019 to July 2019, containing six sets of transect surveys for all monitoring areas. Action Level will be triggered if both STG and ANI fall below the criteria.

Group Size

In July 2019, 33 groups with 137 dolphins were sighted, and the average group size of CWDs was 4.2 dolphins per group. The number of sightings with medium group size (i.e. 3-9 dolphins) is dominant. There were three CWD sightings with large group size (i.e. 10 or more dolphins) in July 2019. Amongst these three sightings, two were recorded in SWL and the remaining one was recorded in WL.

Activities and Association with Fishing Boats

Eleven sightings of CWDs were recorded engaging in feeding activities in July 2019 in NWL, WL and particularly SWL survey areas. It should be noted that there were plenty of schools of fish appeared in SWL survey area during the survey time based on field observation. No CWD sightings were observed in association with operating fishing boat in the reporting month.

Mother-calf Pair

In July 2019, there were four sightings of CWD with the presence of mother-and-unspotted juvenile pair.

6.4.2      Photo Identification

In July 2019, a total number of 63 different CWD individuals were identified for totally 86 times. A summary of photo identification works is presented in Table 6.5. Representative photos of these individuals are given in Appendix C.

Table 6.5: Summary of Photo Identification

Individual ID

Date of Sighting (dd-mmm-yy)

Sighting Group No.

Area

Individual ID

Date of Sighting (dd-mmm-yy)

Sighting Group No.

Area

NLMM001

16-Jul-19

6

WL

WLMM040

17-Jul-19

6

SWL

18-Jul-19

1

SWL

WLMM043

16-Jul-19

1

WL

3

SWL

WLMM046

18-Jul-19

3

SWL

NLMM037

24-Jul-19

1

NWL

WLMM049

16-Jul-19

3

WL

NLMM049

23-Jul-19

6

WL

WLMM052

16-Jul-19

5

WL

NLMM061

17-Jul-19

9

SWL

WLMM056

17-Jul-19

2

SWL

NLMM063

24-Jul-19

1

NWL

WLMM063

17-Jul-19

10

SWL

SLMM003

16-Jul-19

6

WL

WLMM065

17-Jul-19

9

SWL

SLMM007

16-Jul-19

6

WL

WLMM067

17-Jul-19

2

SWL

SLMM012

17-Jul-19

2

SWL

WLMM069

17-Jul-19

4

SWL

18-Jul-19

1

SWL

18-Jul-19

3

SWL

SLMM014

18-Jul-19

4

SWL

WLMM078

18-Jul-19

4

SWL

SLMM022

23-Jul-19

7

WL

WLMM079

18-Jul-19

1

SWL

SLMM028

18-Jul-19

4

SWL

3

SWL

SLMM029

17-Jul-19

3

SWL

23-Jul-19

7

WL

18-Jul-19

1

SWL

WLMM081

16-Jul-19

4

WL

SLMM031

17-Jul-19

1

SWL

WLMM082

16-Jul-19

4

WL

SLMM037

17-Jul-19

5

SWL

23-Jul-19

3

WL

18-Jul-19

1

SWL

WLMM083

16-Jul-19

1

WL

3

SWL

WLMM085

17-Jul-19

4

SWL

SLMM049

17-Jul-19

4

SWL

WLMM086

17-Jul-19

11

SWL

18-Jul-19

1

SWL

WLMM094

16-Jul-19

5

WL

3

SWL

WLMM095

23-Jul-19

1

WL

SLMM050

23-Jul-19

5

WL

WLMM102

23-Jul-19

1

WL

SLMM052

17-Jul-19

2

SWL

WLMM104

18-Jul-19

2

SWL

5

SWL

23-Jul-19

6

WL

18-Jul-19

1

SWL

WLMM109

23-Jul-19

5

WL

3

SWL

WLMM115

22-Jul-19

1

NWL

SLMM053

18-Jul-19

4

SWL

23-Jul-19

1

WL

SLMM062

17-Jul-19

4

SWL

3

WL

18-Jul-19

3

SWL

WLMM120

17-Jul-19

10

SWL

SLMM064

17-Jul-19

4

SWL

WLMM122

16-Jul-19

1

WL

SLMM068

17-Jul-19

2

SWL

WLMM131

17-Jul-19

2

SWL

SLMM069

17-Jul-19

4

SWL

7

SWL

SLMM070

17-Jul-19

4

SWL

10

SWL

18-Jul-19

3

SWL

WLMM132

17-Jul-19

4

SWL

SLMM071

18-Jul-19

1

SWL

18-Jul-19

3

SWL

WLMM004

17-Jul-19

4

SWL

WLMM136

16-Jul-19

5

WL

WLMM006

18-Jul-19

4

SWL

WLMM137

16-Jul-19

5

WL

WLMM008

17-Jul-19

3

SWL

WLMM139

16-Jul-19

4

WL

WLMM027

17-Jul-19

6

SWL

WLMM140

16-Jul-19

4

WL

WLMM029

18-Jul-19

4

SWL

WLMM141

16-Jul-19

5

WL

WLMM039

16-Jul-19

5

WL

WLMM142

23-Jul-19

5

WL

6.4.3      Land-based Theodolite Tracking Survey

Survey Effort

Land-based theodolite tracking surveys were conducted at LKC on 16 and 25 July 2019 and at SC on 26 July 2019, with a total of three days of land-based theodolite tracking survey effort accomplished in this reporting period. Three CWD groups were tracked at LKC station during the surveys. Information of survey effort and CWD groups sighted during these land-based theodolite tracking surveys are presented in Table 6.6. Details of the survey effort and CWD groups tracked are presented in Appendix C. The first sighting locations of CWD groups tracked at LKC station during land-based theodolite tracking surveys in July 2019 were depicted in Figure 6.4. No CWD group was sighted from SC station in this reporting month.

Table 6.6: Summary of Survey Effort and CWD Group of Land-based Theodolite Tracking

Land-based Station

No. of Survey Sessions

Survey Effort (hh:mm)

No. of CWD Groups Sighted

CWD Group Sighting per Survey Hour

Lung Kwu Chau

2

12:00

3

0.25

Sha Chau

1

6:00

0

0

TOTAL

3

18:00

3

0.17

Figure 6.4: Plots of First Sightings of All CWD Groups obtained from Land-based Stations

6.5         Progress Update on Passive Acoustic Monitoring

Underwater acoustic monitoring using Passive Acoustic Monitoring (PAM) should be undertaken during land formation related construction works. In this reporting period, the Ecological Acoustic Recorder (EAR) was retrieved on 16 July 2019 and subsequently redeployed and positioned at south of Sha Chau Island inside the SCLKCMP with 20% duty cycle (Figure 6.5). The EAR deployment is generally for 6 weeks prior to data retrieval for analysis. Acoustic data is reviewed to give an indication of CWDs occurrence patterns and to obtain anthropogenic noise information simultaneously. Analysis (by a specialized team of acousticians) involved manually browsing through every acoustic recording and logging the occurrence of dolphin signals. All data will be re-played by computer as well as listened to by human ears for accurate assessment of dolphin group presence. As the period of data collection and analysis takes more than four months, PAM results could not be reported in monthly intervals but report for supplementing the annual CWD monitoring analysis.

6.6         Site Audit for CWD-related Mitigation Measures

During the reporting period, silt curtains were in place by the contractor for marine filling , in which dolphin observers were deployed by contractor in accordance with the MMWP. Overall, 7 to 12 dolphin observation stations and teams of at least two dolphin observers were deployed by the contractors for continuous monitoring of the DEZ for DCM works and seawall construction in accordance with the DEZ Plan. Trainings for the proposed dolphin observers on the implementation of MMWP and DEZ monitoring were provided by the ET prior to the aforementioned works, with a cumulative total of 677 individuals being trained and the training records kept by the ET. From the contractors’ MMWP observation records, no dolphin or other marine mammals were observed within or around the silt curtains. As for DEZ monitoring records, no dolphin or other marine mammals were observed within or around the DEZs in this reporting month. These contractors’ records were also audited by the ET during site inspection. On 8 July 2019, a dolphin carcass was found within the works area and subsequent inspection and collection of the dolphin carcass was carried out by AFCD.

Audits of acoustic decoupling measures for construction vessels were carried out during weekly site inspection and the observations are summarised in Section 7.1. Audits of SkyPier high speed ferries route diversion and speed control and construction vessel management are presented in Section 7.2 and Section 7.3 respectively.

6.7         Timing of Reporting CWD Monitoring Results

Detailed analysis of CWD monitoring results collected by small vessel line-transect survey will be provided in future quarterly reports. Detailed analysis of CWD monitoring results collected by land-based theodolite tracking survey and PAM will be provided in future annual reports after a larger sample size of data has been collected.

6.8         Summary of CWD Monitoring

Monitoring of CWD was conducted with two complete sets of small vessel line-transect surveys and three days of land-based theodolite tracking survey effort as scheduled. The running quarterly encounter rates STG and ANI in the reporting period did not trigger the Action Level for CWD monitoring.

7        Environmental Site Inspection and Audit

7.1         Environmental Site Inspection

Site inspections of the construction works were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures for the Project. The weekly site inspection schedule of the construction works is provided in Appendix B. Bi-weekly site inspections were also conducted by the IEC. Besides, ad-hoc site inspections were conducted by ET and IEC if environmental problems were identified, or subsequent to receipt of an environmental complaint, or as part of the investigation work. These site inspections provided a direct means to reinforce the specified environmental protection requirements and pollution control measures in construction sites.

During site inspections, environmental situation, status of implementation of pollution control and mitigation measures were observed. Environmental documents and site records, including waste disposal record, maintenance record of environmental equipment, and relevant environmental permit and licences, were also checked on site. Observations were recorded in the site inspection checklist and passed to the contractor together with the appropriate recommended mitigation measures where necessary in order to advise contractors on environmental improvement, awareness and on-site enhancement measures. The observations were made with reference to the following information during the site inspections:

·         The EIA and EM&A requirements;

·         Relevant environmental protection laws, guidelines, and practice notes;

·         The EP conditions and other submissions under the EP;

·         Monitoring results of EM&A programme;

·         Works progress and programme;

·         Proposal of individual works;

·         Contract specifications on environmental protection; and

·         Previous site inspection results.

Good site practices were observed in site inspections during the reporting period. Advice were given when necessary to ensure the construction workforce were familiar with relevant procedures, and to maintain good environmental performance on site. Regular toolbox talks on environmental issues were organized for the construction workforce by the contractors to ensure understanding and proper implementation of environmental protection and pollution control mitigation measures.

During the reporting period, implementation of recommended landscape and visual mitigation measures (CM1 – CM10) where applicable was monitored weekly in accordance with the Manual and no non-conformity was recorded. In case of non-conformity, specific recommendations will be made, and actions will be proposed according to the Event and Action Plan. The monitoring status is summarized in Appendix A.

A summary of implementation status of the environmental mitigation measures for the construction phase of the Project during the reporting period is provided in Appendix A.

7.2         Audit of SkyPier High Speed Ferries

The Marine Travel Routes and Management Plan for High Speed Ferries of SkyPier (the SkyPier Plan) was submitted to the Advisory Council on the Environment for comment and subsequently submitted to and approved by EPD in November 2015 under EP Condition 2.10. The approved SkyPier Plan is available on the dedicated website of the Project. In the SkyPier Plan, AAHK has committed to implement the mitigation measure of requiring HSFs of SkyPier travelling between HKIA and Zhuhai / Macau to start diverting the route with associated speed control across the area, i.e. Speed Control Zone (SCZ), with high CWD abundance. The route diversion and speed restriction at the SCZ have been implemented since 28 December 2015.

Key audit findings for the SkyPier HSFs travelling to/from Zhuhai and Macau against the requirements of the SkyPier Plan during the reporting period are summarized in Table 7.1.  The daily movements of all SkyPier HSFs in this reporting period (i.e., 33 to 83  daily movements were within the maximum daily cap of 125 daily movements. Status of compliance with the annual daily average of 99 movements will be further reviewed in the annual EM&A Report.

In total, 640 ferry movements between HKIA SkyPier and Zhuhai / Macau were recorded in July 2019 and the data are presented in Appendix G. The time spent by the SkyPier HSFs travelling through the SCZ in July 2019  were presented in Figure 7.1.  It will take 9.6 minutes to travel through the SCZ when the SkyPier HSFs adopt the maximum allowable speed of 15 knots within the SCZ. Figure 7.1 shows that all of the SkyPier HSFs spent more than 9.6 minutes to travel through the SCZ.

Figure 7.1: Duration of the SkyPier HSFs travelling through the SCZ for July 2019

Note: Data above the red line indicated that the time spent by the SkyPier HSFs travelling through the SCZ is more than 9.6 minutes, which is in compliance with the SkyPier Plan.

A total of one ferry was recorded with minor route deviation on 26 July 2019. Notice was sent to the ferry operator and the case is under investigation by ET.

As reported in the Construction Phase Monthly EM&A Report No. 42, two ferries were recorded with minor route deviation cases on 10 and 17 June 2019. ET’s investigation found that all the deviations were due to giving way to vessels in order to avoid collision.

Table 7.1: Summary of Key Audit Findings against the SkyPier Plan

Requirements in the SkyPier Plan

1 to 31 July 2019

Total number of ferry movements recorded and audited

640

Use diverted route and enter / leave SCZ through Gate Access Points

1 deviation

Speed control in speed control zone

The average speeds of all HSFs travelling through the SCZ ranged from 10.3 to 13.8 knots. All HSFs had travelled through the SCZ with average speeds under 15 knots in compliance with the SkyPier Plan. The time used by HSFs to travel through SCZ is presented in Figure 7.1.

Daily Cap (including all SkyPier HSFs)

33-83 daily movements (within the maximum daily cap - 125 daily movements).

7.3         Audit of Construction and Associated Vessels

The updated Marine Travel Routes and Management Plan for Construction and Associated Vessel (MTRMP-CAV) was submitted and approved in November 2016 by EPD under EP Condition 2.9. The approved Plan is available on the dedicated website of the Project.

ET carried out the following actions during the reporting period:

7.4         Implementation of Dolphin Exclusion Zone

The DEZ Plan was submitted in accordance with EP Condition 3.1 (v) requirement and Section 10.3 of the Manual, and approved in April 2016 by EPD. The 24-hour DEZs with a 250m radius for marine works were established and implemented by the contractors for DCM works and seawall construction according to their Method Statement for DEZ Monitoring that followed the specifications and requirements of the DEZ Plan.

During the reporting period, ET was notified that no dolphin sightings were recorded within the DEZ by the contractors. The ET checked the relevant records by the contractors and conducted competence checking to audit the implementation of DEZ.

7.5         Status of Submissions under Environmental Permits

The current status of submissions under the EP up to the reporting period is presented in Table 7.2

Table 7.2: Status of Submissions under Environmental Permit

EP Condition

Submission

Status

2.1

Complaint Management Plan

Accepted / approved by EPD

2.4

Management Organizations

2.5

Construction Works Schedule and Location Plans

2.7

Marine Park Proposal

2.8

Marine Ecology Conservation Plan

2.9

Marine Travel Routes and Management Plan for Construction and Associated Vessels

2.10

Marine Travel Routes and Management Plan for High Speed Ferries of SkyPier

2.11

Marine Mammal Watching Plan

2.12

Coral Translocation Plan

2.13

Fisheries Management Plan

2.14

Egretry Survey Plan

2.15

Silt Curtain Deployment Plan

2.16

Spill Response Plan

2.17

Detailed Plan on Deep Cement Mixing

2.18

Landscape & Visual Plan

Submitted to EPD

2.19

Waste Management Plan

Accepted / approved by EPD

2.20

Supplementary Contamination Assessment Plan

3.1

Updated EM&A Manual

3.4

Baseline Monitoring Reports

7.6         Compliance with Other Statutory Environmental Requirements

During the reporting period, environmental related licenses and permits required for the construction activities were checked. No non-compliance with environmental statutory requirements was recorded. The environmental licenses and permits which are valid in the reporting period are presented in Appendix E.

7.7         Analysis and Interpretation of Complaints, Notification of Summons and Status of Prosecutions

7.7.1      Complaints

No construction activities-related complaint was received during the reporting period.

7.7.2      Notifications of Summons or Status of Prosecution

Neither notification of summons nor prosecution was received during the reporting period.

7.7.3      Cumulative Statistics

Cumulative statistics on complaints, notifications of summons and status of prosecutions are summarized in Appendix F.

8        Future Key Issues and Other EIA & EM&A Issues

8.1         Construction Programme for the Coming Reporting Period

Key activities anticipated in the next reporting period for the Project will include the following:

Advanced Works:

Contract P560 (R) Aviation Fuel Pipeline Diversion Works

    Stockpiling of compressed materials

DCM Works:

Contract 3201 and 3205 DCM Works

    DCM works

Reclamation Works:

Contract 3206 Main Reclamation Works

    Land base ground improvement works;

    Seawall construction; and

    Marine filling.

Airfield Works:

Contract 3301 North Runway Crossover Taxiway

    Cable ducting works;

    Subgrade compaction and paving works;

    Drainage construction works;

    Operation of aggregate mixing facility; and

    Precast of duct bank and fabrication of steel works.

Contract 3302 Eastern Vehicular Tunnel Advance Works

    Site survey and cable laying;

    Excavation works;

    Backfilling and reinstatement works; and

    Site establishment.

Contract 3303 Third Runway and Associated Works

    Site establishment.

Third Runway Concourse and Integrated Airport Centres Works:

Contract 3402 New Integrated Airport Centres Enabling Works

    Sub-structure and superstructure works;

    Structural steel fabrication;

    Paving works; and

    Manhole and pipe construction works.

Terminal 2 Expansion Works:

Contract 3501 Antenna Farm and Sewage Pumping Station

    Drainage works;

    Boring works; and

    Pipe installation.

Contract 3502 Terminal 2 Automated People Mover (APM) Depot Modification Works

    Site clearance; and

    Fitting out works.

Contract 3503 Terminal 2 Foundation and Substructure Works

    Site establishment;

    Demolition works;

    Utilities, drainage, and road work; and

    Piling and structure works.

Automated People Mover (APM) Works:

Contract 3602 Existing APM System Modification Works

    Site establishment; and

    Modification works at APM depot.

Airport Support Infrastructure & Logistic Works:

Contract 3801 APM and BHS Tunnels on Existing Airport Island

    Site establishment;

    Cofferdam installation and construction of box culvert;

    Rising main installation;

    Drilling and grouting works;

    Piling and foundation works

    Demolition works; and

    Site clearance.

8.2         Key Environmental Issues for the Coming Reporting Period

The key environmental issues for the Project in the coming reporting period expected to be associated with the construction activities include:

    Generation of dust from construction works and stockpiles;

    Noise from operating equipment and machinery on-site;

    Generation of site surface runoffs and wastewater from activities on-site;

    Water quality from DCM works and marine filling;

    DEZ monitoring for ground improvement works (DCM works) and seawall construction;

    Implementation of MMWP for silt curtain deployment;

    Sorting, recycling, storage and disposal of general refuse and construction waste;

    Management of chemicals and avoidance of oil spillage on-site; and

    Acoustic decoupling measures for equipment on marine vessels.

The implementation of required mitigation measures by the contractors will be monitored by the ET.

8.3         Monitoring Schedule for the Coming Reporting Period

A tentative schedule of the planned environmental monitoring work in the next reporting period is provided in Appendix B.

8.4         Review of the Key Assumptions Adopted in the EIA Report

With reference to Appendix E of the Manual, it is noted that the key assumptions adopted in approved EIA report for the construction phase are still valid and no major changes are involved. The environmental mitigation measures recommended in the approved EIA Report remain applicable and shall be implemented in undertaking construction works for the Project.

9        Conclusion and Recommendation

The key activities of the Project carried out in the reporting period included reclamation works and land-side works. Reclamation works included DCM works, marine filling and seawall construction. Land-side works involved mainly airfield works, foundation and substructure work for Terminal 2 expansion, modification and tunnel work for APM and BHS systems, and preparation work for utilities, with activities include site establishment, site office construction, road and drainage works, cable ducting, demolition of existing facilities, piling, and excavation works.

All the monitoring works for construction dust, construction noise, water quality, construction waste, landscape & visual, and CWD were conducted during the reporting period in accordance with the Manual.

Monitoring results of construction dust, construction noise, construction waste, and CWD did not trigger the corresponding Action and Limit Levels during the reporting period.

The water quality monitoring results for turbidity, total alkalinity, SS, chromium, and nickel obtained during the reporting period were within the corresponding Action and Limit Levels stipulated in the EM&A programme. Relevant investigation and follow-up actions will be conducted according to the EM&A programme if the corresponding Action and Limit Levels are triggered. For DO, some testing results triggered the relevant Action or Limit Levels, and the corresponding investigations were conducted accordingly. The investigation findings concluded that the case was not related to the Project. To conclude, the construction activities in the reporting period did not introduce adverse impact to all water quality sensitive receivers.

Weekly site inspections of the construction works were carried out by the ET to audit the implementation of proper environmental pollution control and mitigation measures for the Project. Bi-weekly site inspections were also conducted by the IEC. Site inspection findings were recorded in the site inspection checklists and provided to the contractors to follow up.

On the implementation of the SkyPier Plan, the daily movements of all SkyPier HSFs in July 2019 were in the range of 33 to 83 daily movements, which are within the maximum daily cap of 125 daily movements. A total of 640 HSF movements under the SkyPier Plan were recorded in the reporting period. The average speeds of all HSFs travelling through the SCZ ranged from 10.3 to 13.8 knots. All HSFs had travelled through the SCZ with average speeds under 15 knots in compliance with the SkyPier Plan. One deviation from the diverted route in July 2019 was recorded in the HSF monitoring and is under investigation by the ET. In summary, the ET and IEC have audited the HSF movements against the SkyPier Plan and conducted follow up investigations or actions accordingly.

On the implementation of MTRMP-CAV, the MSS automatically recorded the deviation case such as speeding, entering no entry zone and not travelling through the designated gates. ET conducted checking to ensure the MSS records all deviation cases accurately. Training has been provided for the concerned skippers to facilitate them in familiarising with the requirements of the MTRMP-CAV. Deviations including speeding in the works area, entered no entry zone, and entry from non-designated gates were reviewed by ET. All the concerned captains were reminded by the contractor’s MTCC representative to comply with the requirements of the MTRMP-CAV. The ET reminded contractors that all vessels shall avoid entering the no-entry zone, in particular the Brothers Marine Park and the Sha Chau & Lung Kwu Chau Marine Park. Three-month rolling programmes for construction vessel activities, which ensures the proposed vessels are necessary and minimal through good planning, were also received from contractors.
